Cloud migration costs are hard to forecast for one simple reason: the numbers that matter rarely sit where teams expect them. FinOps teams see this pattern repeatedly. A model looks reasonable on paper, then reality introduces friction, and the run rate starts drifting.
Cloud migration costs include both the one-time cost of moving workloads and the long-term cloud run rate that remains after cutover. For small workloads, costs may start around $20,000 to $100,000, while enterprise cloud migration programs can run into the millions once labor, double-run, compliance, and integration work are included.
This guide walks through the cost mechanics behind that drift and shows how experienced teams structure cloud migration costs so forecasts hold up once workloads start moving.
Key insights for cloud migration costs in 2026
- Cloud migration costs can range from $20,000-$100,000 for small workloads to multi-million-dollar programs for enterprise cloud migration.
- The biggest cost drivers are usually labor, data movement, integration work, and the double-run period, not just compute and storage.
- Cloud migration cost savings usually appear only after workloads stabilize and temporary migration overhead is gone.
- Many enterprises target 20-40% infrastructure cost reductions, but results depend on workload fit, ownership, and post-cutover controls.
- The benefits of migrating to the cloud are broader than cost alone: scalability, faster delivery, stronger cost attribution, and better compliance visibility.
- For enterprise planning, the most reliable model separates project costs from steady-state run costs.
Making sense of cloud migration costs
Cloud migration costs are often underestimated because the obvious items rarely drive the overruns. VM sizes and storage tiers matter, but the real spend sits in labor, data movement, temporary environments, and the operational work needed to keep systems stable after cutover.
In enterprise migrations, this effect compounds. Each workload carries owners, dependencies, compliance scope, and operational habits built over years. When those details are not fully understood at the start, both the migration budget and the steady-state run rate begin to drift in parallel.
The most reliable way to reason about cloud migration costs is to separate what exists only to move workloads from what remains as the long-term cloud bill.

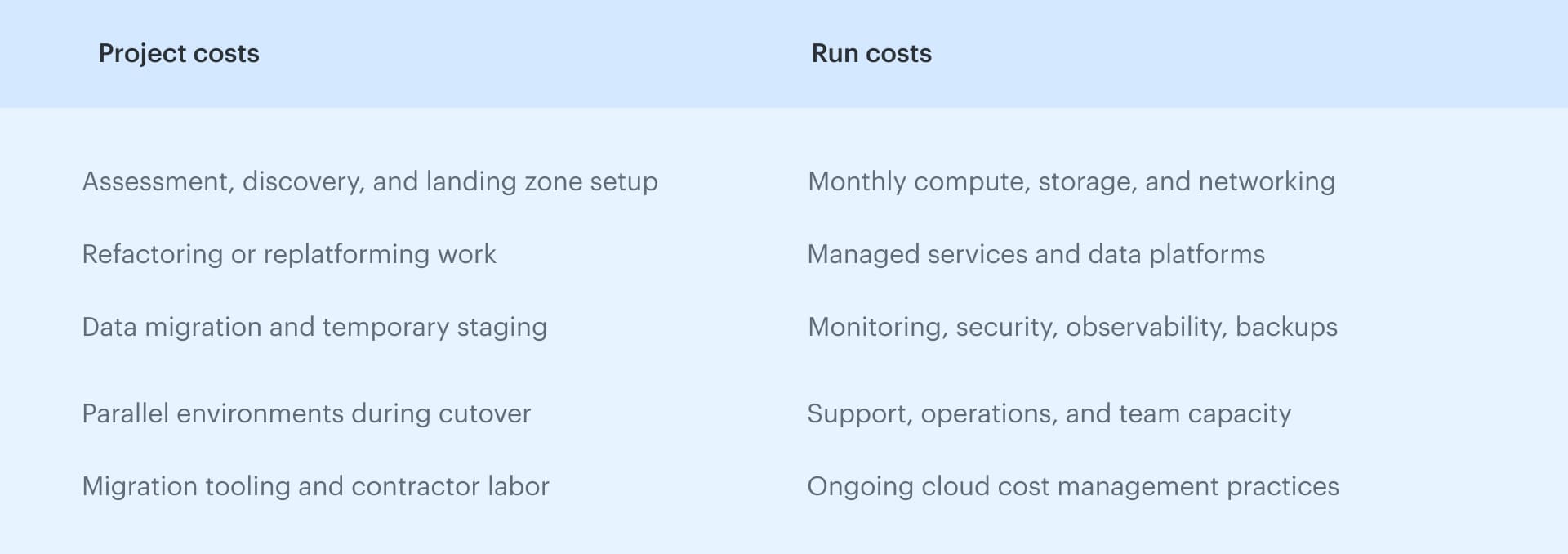

The two cost stacks: project costs vs run costs
Every migration follows the same pattern:
- Project costs are temporary but volatile. These costs disappear after cutover, but they tend to spike when planning is weak.
- Run costs are your long-term cloud bill. These are the charges that determine whether the migration actually produces savings.
Keeping these buckets separate prevents teams from mixing one-time expenses with recurring cloud operational costs. It also makes the business case defensible when Finance reviews assumptions.
Benchmarks by workload size
The first question most teams ask is simple: how much does cloud migration cost? Recent market guides put smaller migrations in the tens of thousands of dollars and larger enterprise programs from the high six figures into the millions, but those numbers are only useful as planning benchmarks.
In practice, cloud migration costs depend less on the provider itself than on workload count, dependency complexity, migration strategy, hybrid overlap, data movement, and compliance scope.
Small workloads: under 100 servers
For smaller estates, cloud migration costs are usually contained because dependencies are limited and coordination overhead stays manageable. Most of the effort sits in initial setup, basic data transfer, and validation rather than deep refactoring or compliance-heavy redesign.
Typical ranges fall between $20,000 and $100,000, depending on how clean the inventory is and whether workloads can move without major changes. In this range, cost models tend to hold because the hybrid period is shorter and ownership is clearer.
Mid-market migrations: 100–500 servers
At this scale, the migration starts behaving like a program rather than a project. Dependencies surface later than expected, integration work expands, and the hybrid period becomes harder to control. This is where cloud migration costs begin to drift if assumptions are not tied to real workloads.
Typical costs move into the $100,000 to $500,000+ range, with a meaningful impact on the first-year run rate. The biggest variables are how much refactoring is required, how long environments overlap, and whether teams stabilize workloads quickly after cutover.
Enterprise cloud migration: 500+ servers and multi-wave programs
Enterprise cloud migration introduces a different cost profile entirely. Workloads move in waves, ownership is distributed across teams, and compliance, audit, and security validation often run in parallel with technical execution. The migration model must account for prolonged double-run, portfolio-level dependencies, and ongoing changes in scope.
Costs typically range from $500,000 to several million dollars, but the more important factor is variability. At this level, cloud migration costs are shaped by governance, coordination, and the ability to control overlap and enforce ownership, not just by technical design.
| Migration size | Typical project costs* | First-year run-cost impact | Main variables |
|---|---|---|---|
| Small workload migration | $20,000-$100,000 | Moderate and easier to model | labor, tooling, data transfer |
| Mid-market migration | $100,000-$500,000+ | Meaningful run-rate change | integration depth, hybrid period, refactoring |
| Enterprise cloud migration | $500,000 to several million | Large and often multi-wave | compliance, double-run, ownership, portfolio complexity |
*Planning benchmarks based on recent vendor and partner estimates; actual totals vary by migration strategy, dependency depth, compliance scope, and overlap period.
How one-time and temporary costs affect cloud migration benefits
Understanding these one-time costs is essential for projecting cloud migration benefits accurately. One-time migration costs cover the work required to prepare, move, and stabilize workloads. These costs disappear after cutover, but they determine how quickly the benefits of cloud migration show up.
When this work takes longer than planned, the savings timeline shifts, and the ROI model changes with it.
Foundation and data movement work that front-loads the budget
Before workloads move, teams build the landing zone: IAM patterns, network layout, encryption, logging, and compliance controls. None of this shows up clearly on a bill, but it requires meaningful engineering time and often external help.
Data movement adds another cost layer. Migrations rarely happen in one pass. Teams run multiple syncs, create temporary snapshots, validate loads, and repeat cycles during testing. Transfer charges, egress, and short-lived storage often become the biggest early spikes, especially when on-prem dependencies draw out the process.
Refactoring, tooling, and organizational work that shape long-term benefits
The 7R framework affects both the upfront migration bill and the long-term cloud run rate. In practice, teams do not “pick an R” in isolation. The right choice comes from three constraints that show up in every enterprise migration:
- Workload behavior. Workloads with frequent change or high business impact often justify refactoring or replatforming. Higher engineering effort can pay back through lower operational cost, better scaling, or reduced support overhead.
- Business priorities. When speed is the primary constraint, rehost is usually the fastest path. In this case, teams need to plan remediation early or accept that inefficiencies will carry into steady state.
- Engineering capacity. Deep refactors only work if the organization can maintain them. A design that looks optimal on paper creates risk when teams lack the skills or time to support it.
Workloads that behave consistently over time usually land between the extremes. Moving them onto managed cloud services tends to produce the best outcome, since teams reduce day-to-day operational effort without taking on the risk of a full rewrite.
In most enterprise programs, migration work also pulls in outside help and short-term tools. Partner time, migration utilities, third-party software licenses, and team training push costs up early. None of this is permanent, but when it is missed in planning, the point where cloud savings show up moves further out than expected.

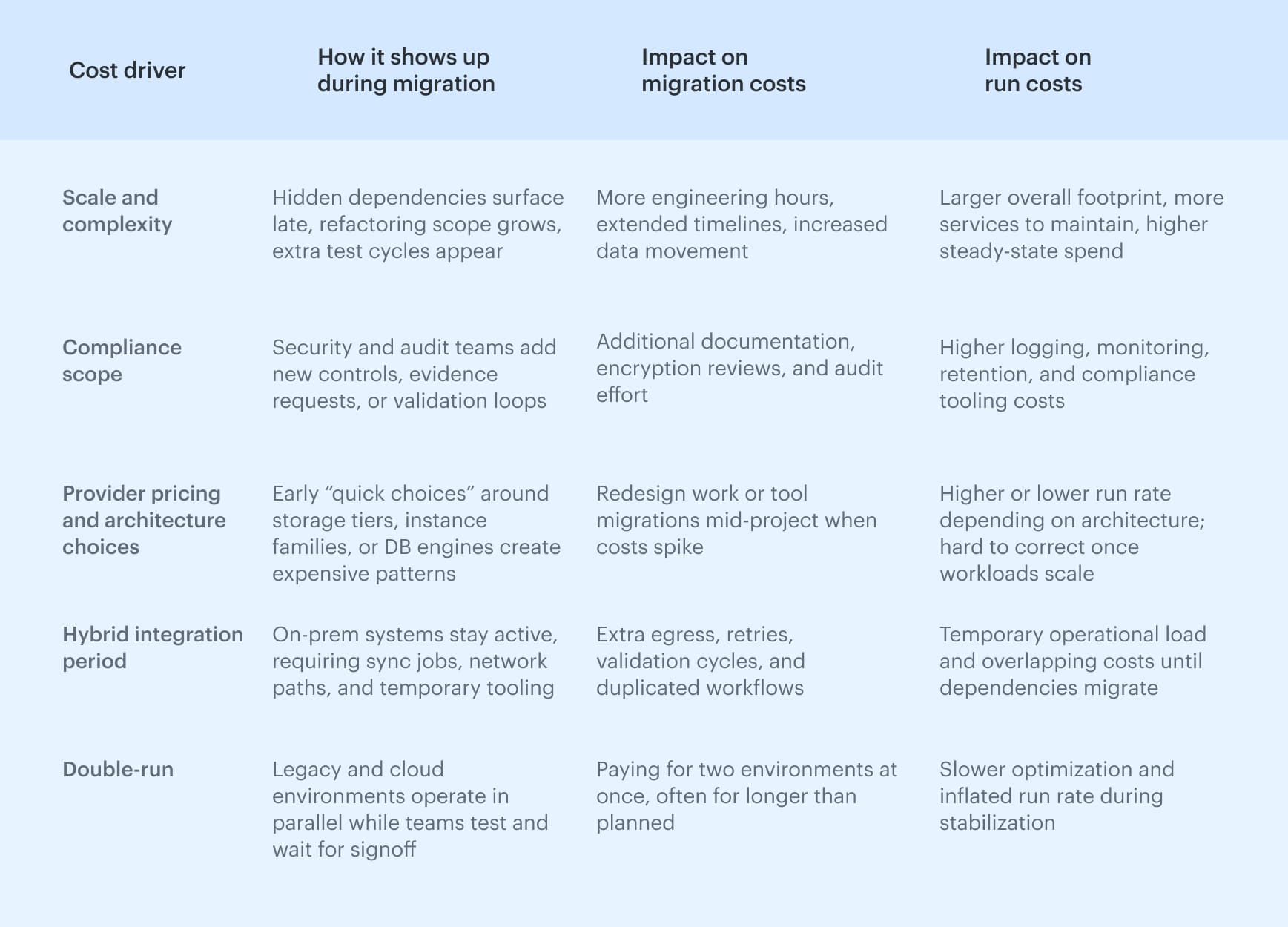

Hidden costs in cloud migration that derail enterprise budgets
Hidden costs in cloud migration usually come from overlap, dependencies, and validation work that were never modeled clearly in the first place.
Most migration forecasts assume the hard part is choosing services, when in reality, cost pressure comes from everything that sits between systems: undocumented dependencies, hybrid operation, and the effort required to prove that workloads are safe to move and run.
The double-run period
Double-run remains the most common source of budget overruns. Teams plan for a short overlap, but in practice testing takes longer, approvals slip, and cutover gets delayed. Legacy and cloud environments end up running in parallel while performance is validated, edge cases are resolved, and business sign-off moves through the organization.
Without firm ownership and clear cutover criteria, this overlap quietly becomes one of the largest migration expenses. Every additional week means duplicated cost across:
- Compute and storage in both environments
- Legacy and cloud licensing
- Support and operations effort
- Temporary networking and data-transfer paths
What starts as a temporary phase often turns into a prolonged period where both stacks are fully active, and expected savings never materialize on time.
Read also: Compliance Across a Multi-Cloud Setup - Case Study
Integration and dependency costs
Integration work compounds almost every migration cost assumption. Inventories often appear complete until an untracked server or undocumented dependency shows up. At that point, sizing assumptions shift and estimates move with them.
Large application portfolios expose this quickly. A workload planned for a simple rehost may depend on:
- On-prem identity systems
- Reporting platforms and shared databases
- Batch jobs and shared libraries
- Sync jobs, retries, and temporary network paths
Once these dependencies surface, the migration path changes and engineering effort expands. Integration work touches identity, networking, data, and security at the same time, which is why it consistently shows up as one of the least predictable cost drivers.
Read also: One IT Asset Management Guide to Rule Your Hybrid Cloud Setup
Training, change management, and productivity loss
Migration programs also create temporary productivity loss. Teams spend time learning new operating models, validating unfamiliar tooling, and supporting old and new environments at the same time. Even when this cost never appears as a line item in the cloud bill, it affects delivery speed and total migration effort.
In most enterprise migrations, partner involvement, migration tooling, and internal enablement add another layer of effort early in the program. These costs are not permanent, but when they are not planned explicitly, they shift timelines and delay the point where cloud migration benefits become visible.
Read also: 9 parts of IT Asset Management Policy That Works for Hybrid Setup
Compliance and security validation costs
Compliance adds its own layer of friction to enterprise cloud migration. Encryption validation, PCI evidence, audit trails, and security approvals often take as long as the technical work itself. These requirements rarely appear in early estimates, yet they influence both timelines and cost behavior once execution begins.
Because compliance work spans multiple teams and systems, delays tend to cascade. A single control gap can block cutover, extend the double-run period, and increase both project and run costs at the same time.
In enterprise cloud migration, a CMDB-backed inventory reduces compliance validation effort because teams can tie workloads, owners, environments, and controls back to a stable system of record. When that mapping exists from the start, validation becomes a controlled process instead of a late-stage bottleneck that reshapes the entire migration budget.
Why do enterprises underestimate migration expenses?
- Inventories often appear complete until an untracked server or undocumented dependency shows up. At that point, sizing assumptions shift and estimates move with them
- Ownership gaps have a similar effect. When no one is clearly responsible for a workload, forecasts lose accountability. Spend drifts, corrections stall, and Finance later flags the costs as unallocated.
- Double-run lasts too long while teams plan for a short overlap. In practice, testing takes longer, approvals slip, and cutover gets delayed. The legacy and cloud stacks run together, quietly becoming one of the largest costs in the migration.
- Integration work compounds all of this. Identity systems, firewall rules, legacy databases, and audit requirements introduce effort that rarely appears in early budgets, yet touches nearly every enterprise migration.
Cloud workload migration cost savings 2024-2025 vs 2026
Cloud workload migration cost savings in 2024 and 2025, and broader cloud migration cost savings 2024-2025 planning, looked very different from what teams expect in 2026. Not because cloud pricing changed overnight, but because organizations learned where migration models actually break.
Earlier plans assumed savings would appear naturally after cutover. In practice, most savings were delayed or lost because costs became opaque during migration. Ownership drifted, environments overlapped longer than planned, and Finance had no stable way to validate whether the run rate was improving or just shifting.
Three changes now define how enterprises approach migration cost savings in 2026.
What will change in enterprise migration planning in 2026
- Double-run is treated as a financial risk, not a scheduling detail. Teams no longer assume a clean cutover. Parallel environments are budgeted explicitly, timeboxed, and tracked as a risk with clear owners. This alone prevents months of silent double spend.
- Finance expects ranges, not single-point forecasts. FP&A teams now require best, likely, and worst-case scenarios tied to real workloads. They want to know which assumptions move the numbers and what breaks if dependencies surface late. One “approved number” is no longer enough.
- Allocation must work before workloads move. Tagging and ownership are no longer cleanup tasks. Without allocation in place from day one, early cloud bills land as unallocated spend and savings become impossible to prove. In 2026, migration success is measured as much by cost attribution as by technical completion.
Read also: 7 Cloud Cost Allocation Strategies from FinOps Experts
An enterprise cost model you can hand to Finance
Once teams understand where migration costs actually come from, the next challenge is turning that knowledge into a model that Finance can approve and defend. This is where many migration plans stall.
Finance is not looking for a perfect number. They are looking for a model that explains why the number moves. If the forecast changes every time a dependency surfaces or an environment appears, confidence disappears fast.
The migration cost models that survive review share three traits. They are built on real inventory, they make ownership explicit, and they document assumptions clearly enough that Finance can test them.
Why most migration cost models fail the review
Many models collapse because they are built too early and too abstractly. They rely on averages, idealized architectures, or pricing calculators without context. As soon as workloads start moving, those assumptions stop holding.
When Finance asks simple questions — “Which workloads drive this increase?” or “What happens if cutover slips by a month?” — the model cannot answer without a rewrite. That is usually where trust breaks down.
What Finance actually needs from a migration model
A usable model does not need to predict the future perfectly. It needs to stay stable as reality changes. That means:
- Costs tied to named workloads, not generic resource pools
- Clear separation between one-time migration spend and recurring run costs
- Scenario ranges that show best, likely, and worst cases
- Assumptions that can be traced back to inventory, usage, or ownership
When those elements are present, Finance can review, challenge, and approve the model without restarting the conversation every time the plan shifts.
Using CMDB-backed inventory as the source of truth
A cost model only works when it reflects the real environment. A CMDB-backed inventory provides that grounding, especially in enterprise migrations where workloads span dozens of owners and environments.
- Owners. Every workload needs a clear business and technical owner. Without owners, forecasts drift and accountability disappears during cutover.
- Environments. Tagging dev, stage, prod, and shared environments ensures the model accounts for every resource, including the ones that should not move.
- App, service, infra mapping. Mapping at this level exposes dependencies early. This prevents a simple rehost plan from turning into an unexpected replatform effort halfway through migration.
- Accurate baseline from day zero. When inventory, utilization, and ownership come from the CMDB, the baseline reflects what actually exists.
This is the difference between an enterprise cloud migration forecast that Finance trusts and one that collapses under review.
What benefits of cloud migration do enterprises actually gain
The benefits of cloud migration are not limited to lower infrastructure costs. For enterprises, the bigger gains often come from flexibility, operating speed, cleaner ownership, and better control over change, compliance, and long-term run costs.
Direct cost savings vs. On-premises infrastructure
Most cloud migration cost savings do not come from a single pricing advantage. They come from changing the cost structure itself: removing fixed-capacity overhead, reducing infrastructure maintenance, and aligning resource usage more closely with actual demand.
| Cost area | On-premises infrastructure | After cloud migration |
|---|---|---|
| Capacity model | Built for peak demand and future headroom | Scales closer to real workload demand |
| Hardware lifecycle | Requires periodic server and storage refresh | No hardware refresh cycle to fund |
| Unused capacity | Idle resources often remain in place | Easier to identify, rightsize, or retire |
| Operations effort | Teams maintain infrastructure, patching, and supporting systems | More effort shifts to managed services and higher-value operational work |
Most savings come from removing idle on-prem capacity, avoiding hardware refresh cycles, and running workloads at actual utilization rather than provisioned peak levels. Managed services reduce operational overhead, while early cleanup improves results further, since the cheapest workload to run in the cloud is the one you never migrate.
Operational and business benefits of migrating to the cloud
Cloud environments remove provisioning bottlenecks and make operating models less rigid. Teams can:
- Scale resources up or down as demand changes
- Provision environments faster without long infrastructure lead times
- Release changes more quickly without waiting on hardware or capacity approvals
- Adopt managed services that reduce operational maintenance
Cloud migration benefits for the enterprise
At enterprise scale, the biggest benefit is structure. Clear ownership improves cost allocation and accountability, while consistent tagging and inventory make spend explainable from day one.
Compliance validation becomes faster because controls can be mapped directly to workloads and environments. With this foundation, legacy infrastructure can be retired cleanly, and post-cutover governance remains stable instead of drifting.
Cost optimization strategies for cloud migration for the enterprise
Cloud migration does not produce savings by default. Cost outcomes are set by decisions made before the first workload moves, reinforced during execution, and either locked in or lost after cutover.
Teams that treat optimization as a post-migration task usually spend the first quarter correcting avoidable mistakes. Teams that plan cost controls alongside the migration reduce waste while the environment is still flexible.
Before migration: remove costs that should never move
The cheapest workload to run in the cloud is the one you never migrate. Retiring unused or low-value applications reduces both migration effort and future run costs.
- Oversized on-prem servers should be normalized before mapping to cloud instances. Lifting legacy overprovisioning into the cloud turns historical safety margins into immediate spend.
- Tagging and ownership must be fixed upfront. Without clear owners before migration, forecasts break, and early cloud bills arrive as unallocated spend.
During execution: control the messy middle
Most overruns happen here. Staging, testing, and parallel environments tend to outlive their purpose. Timeboxing these environments is one of the fastest ways to protect the budget.
- Data movement needs explicit design. Repeated syncs, hybrid traffic, and cross-region transfers often incur egress costs that were not accounted for in planning.
- Rehost decisions are not always final. Some workloads only stabilize after a quick replatform. Delaying that decision increases redesign effort and mid-migration spend.
Once workloads stabilize, attention shifts to steady-state cost control.
- Rightsizing and autoscaling should be reviewed within weeks, using real production usage. Waiting preserves migration-phase sizing.
- Commitments such as Savings Plans or RIs should follow stabilization, not precede it. Early purchases lock in inefficient patterns.
- Storage tiering, lifecycle rules, tagging, budgets, and alerts keep costs tied to owners. Without them, drift usually appears within the first 60–90 days.

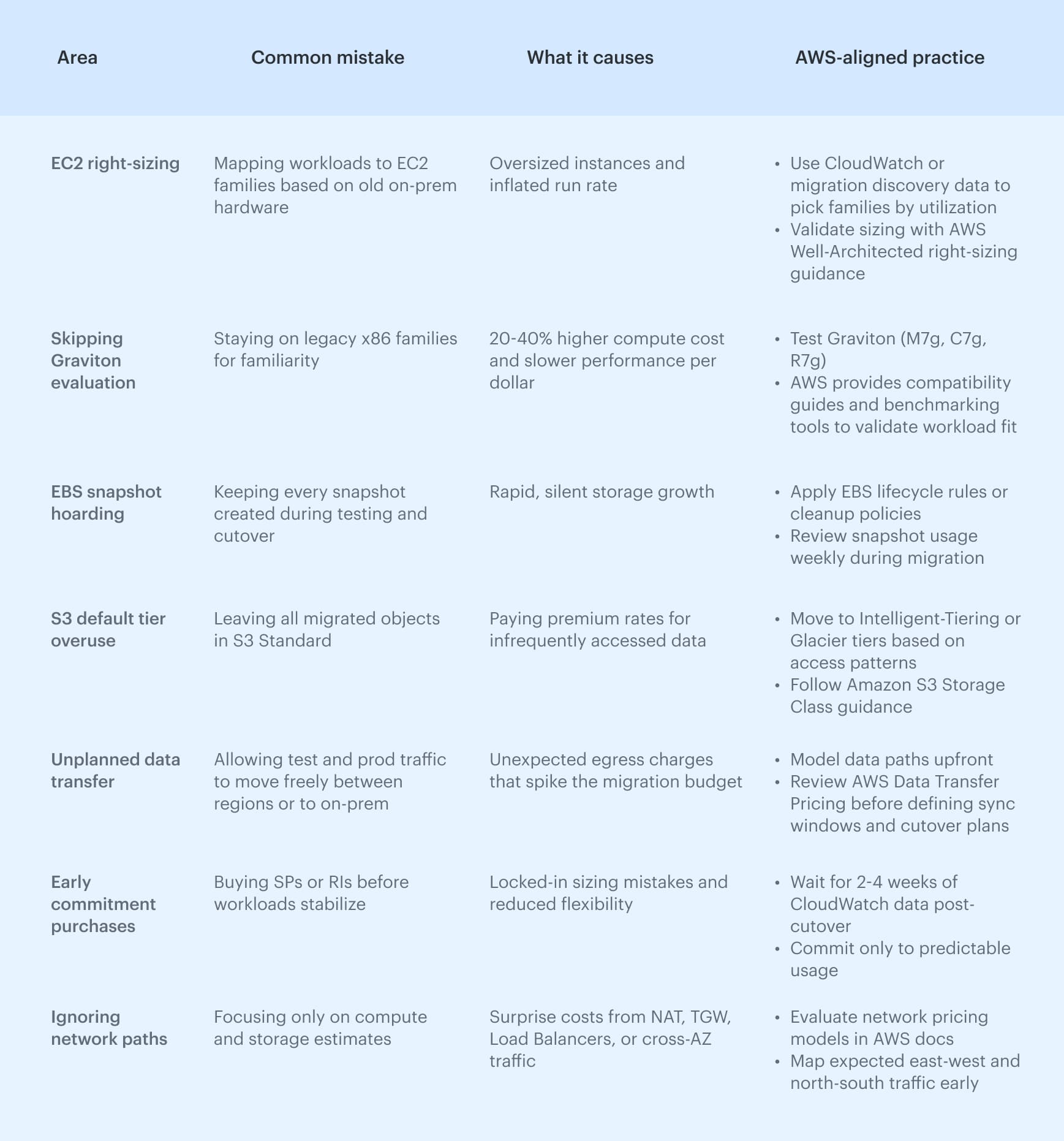

AWS-specific cloud migration costs
AWS migrations introduce cost patterns that rarely show up in early forecasts. The services are familiar, but the way they behave during migration is not. Most “first bill shock” moments come from compute sizing habits, storage defaults, and data movement that only becomes visible once workloads are live.
Compute, storage, egress, transfer, and DMS tooling
The biggest AWS migration costs usually fall into a few categories.
- Compute. Workloads often map into EC2 instance families by habit rather than need. That leads to oversized instances and inflated run costs. Migration windows also create temporary compute usage for staging, validation, and lift-and-shift testing
- Storage. S3 and EBS behave differently from on-prem storage. S3 lifecycle rules are optional, not automatic, and EBS snapshots accumulate quickly during migration testing. Storage spend rises fast if teams do not clear temporary snapshots or move data into the correct tier
- Egress and transfer. Data rarely moves the way teams expect once the migration starts. A small sync job can become a noisy neighbor, and cross-region or hybrid traffic creates real costs that calculators never surface
- AWS DMS. DMS simplifies database moves, but the meter keeps running as long as CDC tasks run. Big tables and long replication windows can turn into noticeable transfer and compute costs if no one keeps an eye on them
Read also: 6 Ways to (not) Fail AWS Cloud Cost Optimization in 2026
EC2 family mapping and right-size modeling
The fastest way to overspend on AWS is to size EC2 based on hardware specs instead of utilization. CPU burst patterns, memory pressure, and IO behavior matter more than core counts.
Teams that use CloudWatch or migration discovery data to pick instance families usually end up with smaller, cheaper, and more stable configurations — especially when they test Graviton.
Read also: AWS Cloud Cost Management - A Practical Guide

Commitments strategy after stabilization
SP and RI can reduce AWS compute costs significantly, but only when purchased at the right time. Buying too early locks in migration-phase sizing, which rarely matches steady-state demand. Buying too late leaves discounts on the table.
Considerations for cloud migration cost savings US
Most US organizations do not operate a single shared cloud environment. They run multi-account AWS, Azure, or GCP structures tied to business units, product lines, or regulatory boundaries. During migration, this adds two requirements:
- Chargeback readiness from day zero. Finance expects cloud costs to be distributed by business unit immediately after workloads move.
This means tagging, ownership, and cost-center alignment must be validated before the migration starts. If not, early cloud bills land as unallocated spend which is a major blocker for US FP&A teams. - Strong governance for account sprawl. As more teams adopt cloud services, US enterprises often see rapid account proliferation. Without clear governance, spend becomes fragmented and savings opportunities (like Savings Plans or shared services) go unused. Migration teams now plan their account hierarchy upfront to avoid rework once workloads are live.
US compliance and operating-model factors
US migration programs also carry cost assumptions that are less visible in generic models. Labor costs for cloud engineers, architects, and compliance teams are often higher, while requirements tied to SOC 2, HIPAA, or FedRAMP-sensitive environments can extend validation work and delay the point at which cloud migration cost savings become visible.
How Cloudaware empowers cloud migration cost savings
After watching dozens of enterprise migrations up close, the pattern is always the same: teams don’t fail because they pick the wrong cloud service. They fail because the financial foundation of the migration is unstable.
Cloudaware fills that gap by giving teams a stable, unified source of truth that holds up even as architectures, owners, and environments shift throughout the migration.
Accurate baseline before migration

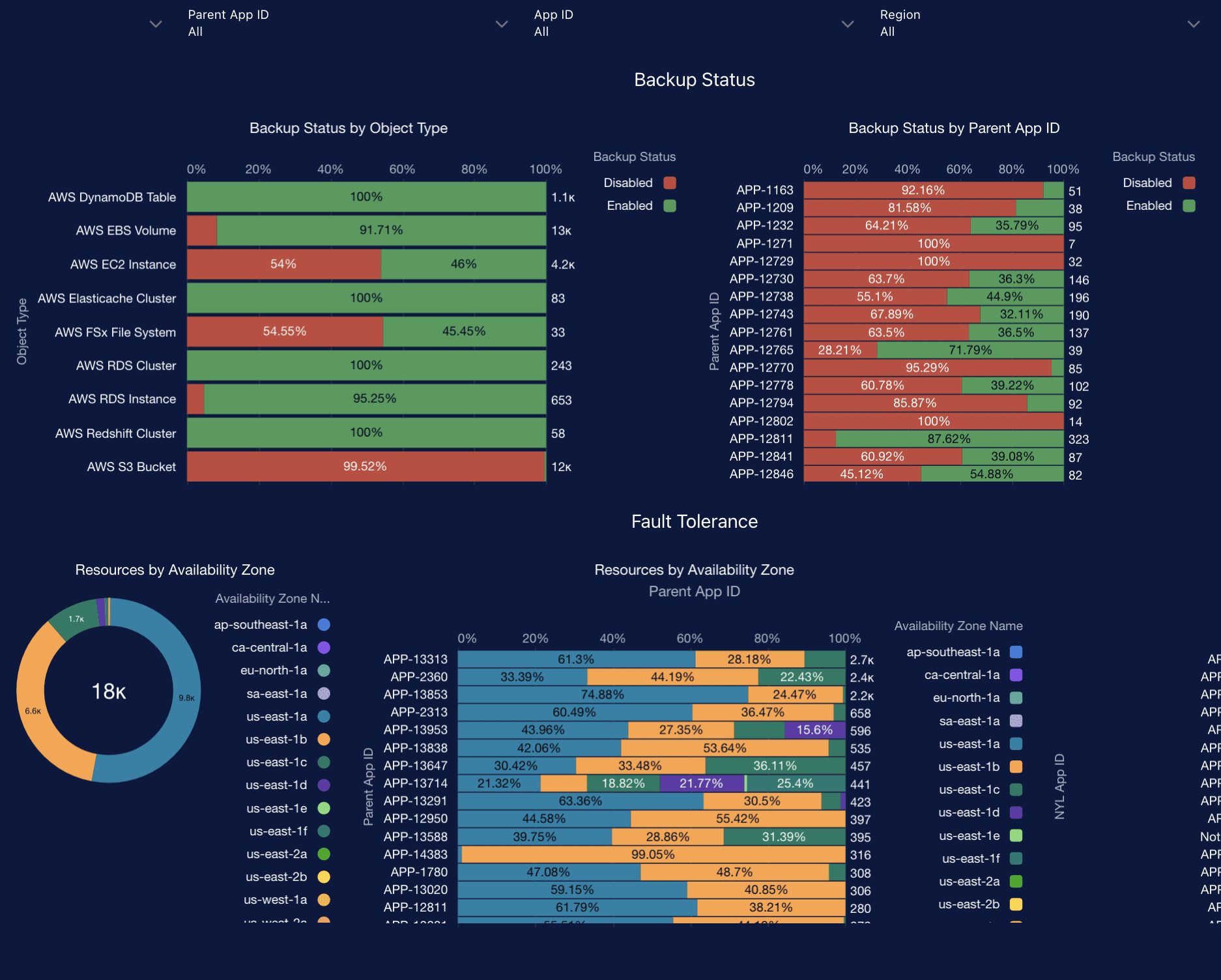

Cloudaware’s CMDB gives you a clean baseline before the first workload moves. Resources are tied to applications, environments, owners, and cost centers, so forecasts do not start with guesswork.
Tag completeness improves because Cloudaware checks metadata across all accounts and providers and pushes exceptions back to the teams responsible.
Daily visibility that keeps costs from drifting
As the migration unfolds, cost patterns change every day. Cloudaware brings in billing and usage data continuously and links it to the CMDB to expose duplicate compute, lingering staging stacks, unplanned egress, unexpected storage growth, and early signs of double-run.
Because spend is tied to applications and services rather than raw resources, FinOps teams get actionable visibility from the first migration wave.
Governance and automation that stabilize post-cutover spend
Cloudaware applies policy and compliance controls to hold the run rate steady after cutover. Tag rules, budget thresholds, drift detection, and environment hygiene checks detect idle resources, mis-tagged assets, and footprints that inflate steady-state costs.
